How to Create a Gantt Chart: Step-by-Step

How to create a Gantt chart step by step — from listing tasks and setting dates to milestones and dependencies, with examples for real projects.

Have your Excel file ready? Upload it and get a presentation-ready Gantt chart in seconds.

Create Gantt chart from Excel →

A Gantt chart turns a project plan into a visual timeline — showing every task, its duration, and how tasks overlap or depend on each other. It's the most widely used project management visualization in the world.

Originally developed by Henry Gantt in the 1910s, the Gantt chart has become standard in construction, software development, event planning, and virtually every industry where work needs to be scheduled and tracked. Today, you can build one in minutes — no project management software subscription required.

In this guide, you'll learn exactly how to create a Gantt chart from scratch, what data you need, which format to use, and how to avoid common mistakes.

Updated October 1, 2026 (usage data refreshed): our separate "Gantt chart maker", "Gantt chart creator" and "disposable Gantt chart" guides now live in this one page, together with a usage-data section (n = 2,689 sessions) and app screenshots of the upload-to-chart flow.

Just want the tool? Open the free Gantt chart maker, upload a task list with start and end dates, and export the timeline as an image. The rest of this guide explains what to put in that task list and how to make the result readable.

What Is a Gantt Chart?

A Gantt chart is a horizontal bar chart that displays a project schedule. Each task is shown as a horizontal bar, positioned on a timeline according to its start date, with the bar's length representing the task's duration. When tasks run in parallel, their bars overlap horizontally.

The key elements of a Gantt chart are:

  • Task list — Rows on the left listing each task or activity
  • Timeline axis — Horizontal axis showing dates (days, weeks, months, or quarters)
  • Task bars — Horizontal bars spanning each task's start-to-end duration
  • Milestones — Key dates or deliverables, often shown as diamond markers
  • Dependencies — Arrows showing which tasks must finish before others can start

At a glance, a Gantt chart answers three critical questions: What needs to be done? By when? And what's happening at the same time?

When Should You Use a Gantt Chart?

Use a Gantt chart when you need to plan, schedule, and communicate a sequence of tasks with defined start and end dates.

Gantt charts are the right choice when:

  • Your project has multiple tasks that span different time periods
  • Some tasks depend on others (Task B can't start until Task A finishes)
  • You need to show stakeholders the project timeline at a glance
  • You want to track progress against the original schedule
  • You're coordinating work across multiple team members or departments

When Gantt charts are NOT the right choice

For a full overview of when to use each chart type, see our guide to chart types.

What Data Do You Need for a Gantt Chart?

Every Gantt chart requires at minimum three columns of data:

Column Description Example
Task name The name or label for each activity "Design mockups", "User testing"
Start date When the task begins 2026-03-01
End date (or duration) When the task finishes — or how many days it takes 2026-03-14 (or 14 days)

Optional but useful columns:

  • Assigned to — Team member or department responsible
  • Progress % — How much of the task is complete (used for progress bars)
  • Dependencies — Which task ID this task depends on
  • Category/phase — Used for color-coding task groups

Sample Gantt chart data (CSV format)

Task,Start,End,Phase
Requirements gathering,2026-03-01,2026-03-07,Planning
System architecture,2026-03-05,2026-03-14,Planning
UI/UX design,2026-03-10,2026-03-24,Design
Backend development,2026-03-15,2026-04-11,Development
Frontend development,2026-03-25,2026-04-18,Development
Integration testing,2026-04-12,2026-04-25,Testing
User acceptance testing,2026-04-20,2026-04-30,Testing
Bug fixes,2026-04-26,2026-05-03,Testing
Deployment,2026-05-04,2026-05-07,Launch

Notice that some tasks overlap in time — for example, "Backend development" and "Frontend development" run in parallel. That's exactly what a Gantt chart makes visually clear.

Step-by-Step: Create a Gantt Chart Online

Here's how to create a professional Gantt chart using CleanChart's Gantt chart maker.

Step 1: Prepare your task data

Collect your tasks, start dates, and end dates in a spreadsheet or text file. Keep the format consistent:

  • Dates in YYYY-MM-DD format work most reliably across tools
  • One task per row
  • Use a clear, short task name (max 30-40 characters for readability)

You can export from your existing project management tool as a CSV, or build the list from scratch. If your data is in JSON format, use our JSON to Gantt chart converter.

Step 2: Upload your data

Go to CleanChart's Gantt chart maker and paste your CSV data or upload your file. CleanChart automatically detects date columns and task names. You can also convert directly from:

CleanChart upload screen ready to accept a project task list CSV
Drop a task list (CSV, Excel, JSON and more are all supported) on the upload screen. Files are processed to generate the chart with no stored copy of your rows.

CleanChart asks what kind of data you uploaded so it can tune its chart recommendation. For a task list, picking "Project & Planning" is what points it at the Gantt chart type.

CleanChart asking what kind of data a task list contains, with a Project & Planning category
Picking "Project & Planning" tunes CleanChart's chart recommendation toward a Gantt timeline for task-and-date data.

Step 3: Map your columns

Tell CleanChart which column contains the task name, which contains the start date, and which contains the end date. If you have a phase or category column, map it to the color grouping — this makes different project phases instantly distinguishable.

CleanChart automatically recommending and rendering a Gantt chart from a five-row task list seconds after upload, with a one-click Download Chart button
A five-row task list rendered as a Gantt chart automatically, matching the median 19-second turnaround in the usage data below. The free tier exports this with a watermark; a paid plan removes it and unlocks high-resolution PNG, SVG and PDF.

Step 4: Configure the timeline

Choose the right timeline granularity for your project:

  • Days — Best for short projects (1–4 weeks)
  • Weeks — Best for medium projects (1–3 months)
  • Months — Best for long projects (3+ months)
  • Quarters — Best for annual roadmaps and strategic planning

Step 5: Customize colors and labels

Color-code tasks by phase or team. For color selection principles, see our guide on color in data visualization. Use distinct, non-adjacent hues for each phase so color-blind viewers can still distinguish categories — see our guide to accessible chart colors for specific palette recommendations.

Step 6: Export and share

Export your Gantt chart as a PNG for presentations, SVG for web use, or PDF for printed documents. For PowerPoint-ready exports, see our guide on exporting charts to PowerPoint.

How Long Does It Take? What CleanChart's Usage Data Shows

Most Gantt charts are built for one meeting, one report or one slide, not maintained as a live schedule. CleanChart's own usage data shows how common that is, and how fast the upload-to-chart path above runs, across 2,689 sessions with a recorded chart type.

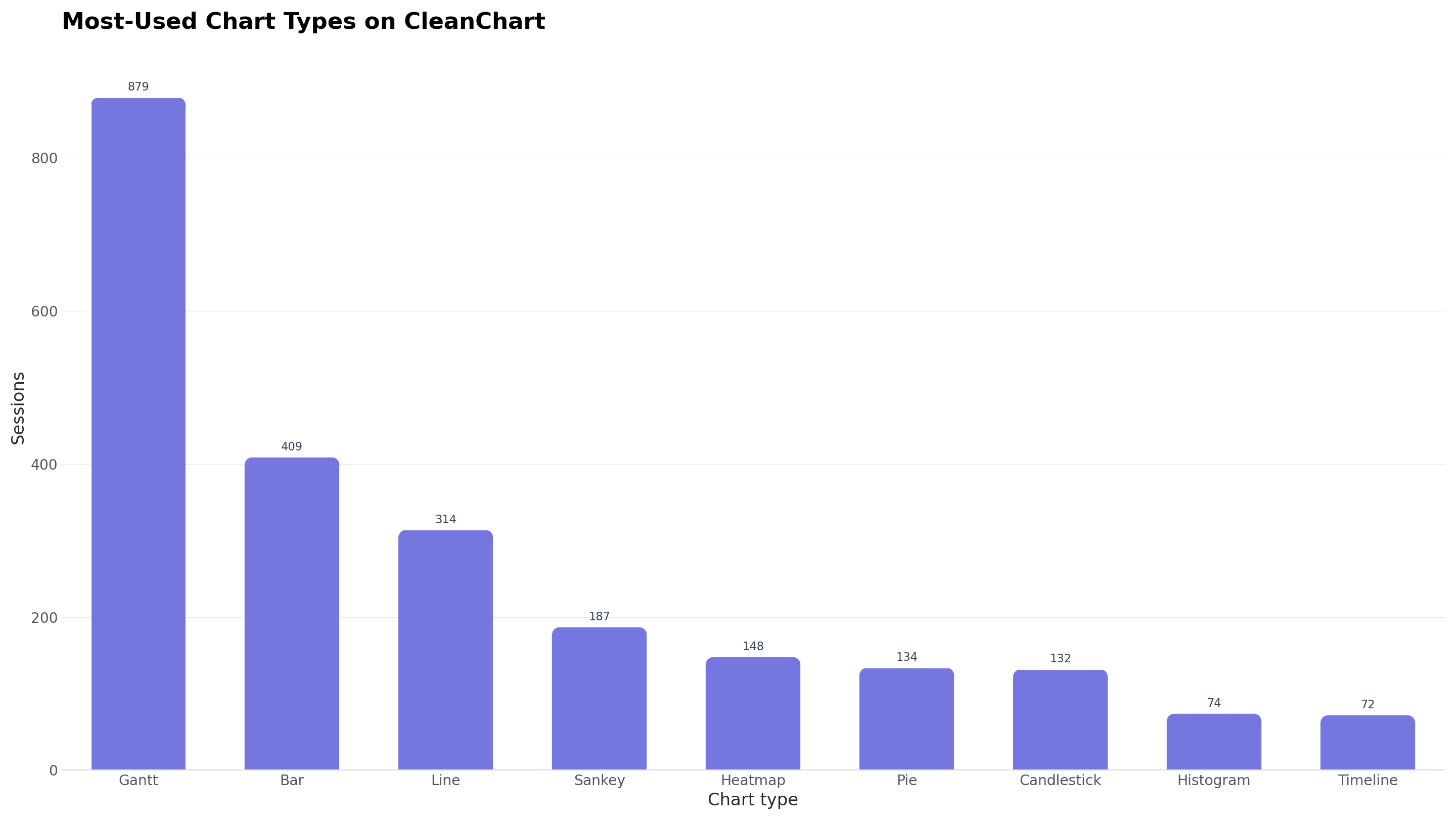

Bar chart of the most-created chart types on CleanChart from May to October 2026: Gantt leads with 879 sessions, ahead of bar (409), line (314), sankey (187), heatmap (148), pie (134), candlestick (132), histogram (74) and timeline (72).
Takeaway: Gantt is the single most-built chart type on CleanChart, at roughly one in three sessions, more than bar and line combined. Most of those are one-off, single-purpose charts: a task list in, a timeline image out. Source: CleanChart usage data, May–Oct 2026, n = 2,689.Download the data (CSV) and recreate this chart in CleanChart's bar chart maker.

Volume alone doesn't say whether people build a quick chart or maintain a living schedule. Speed is the better signal: nobody sets up a recurring workflow just to answer one question.

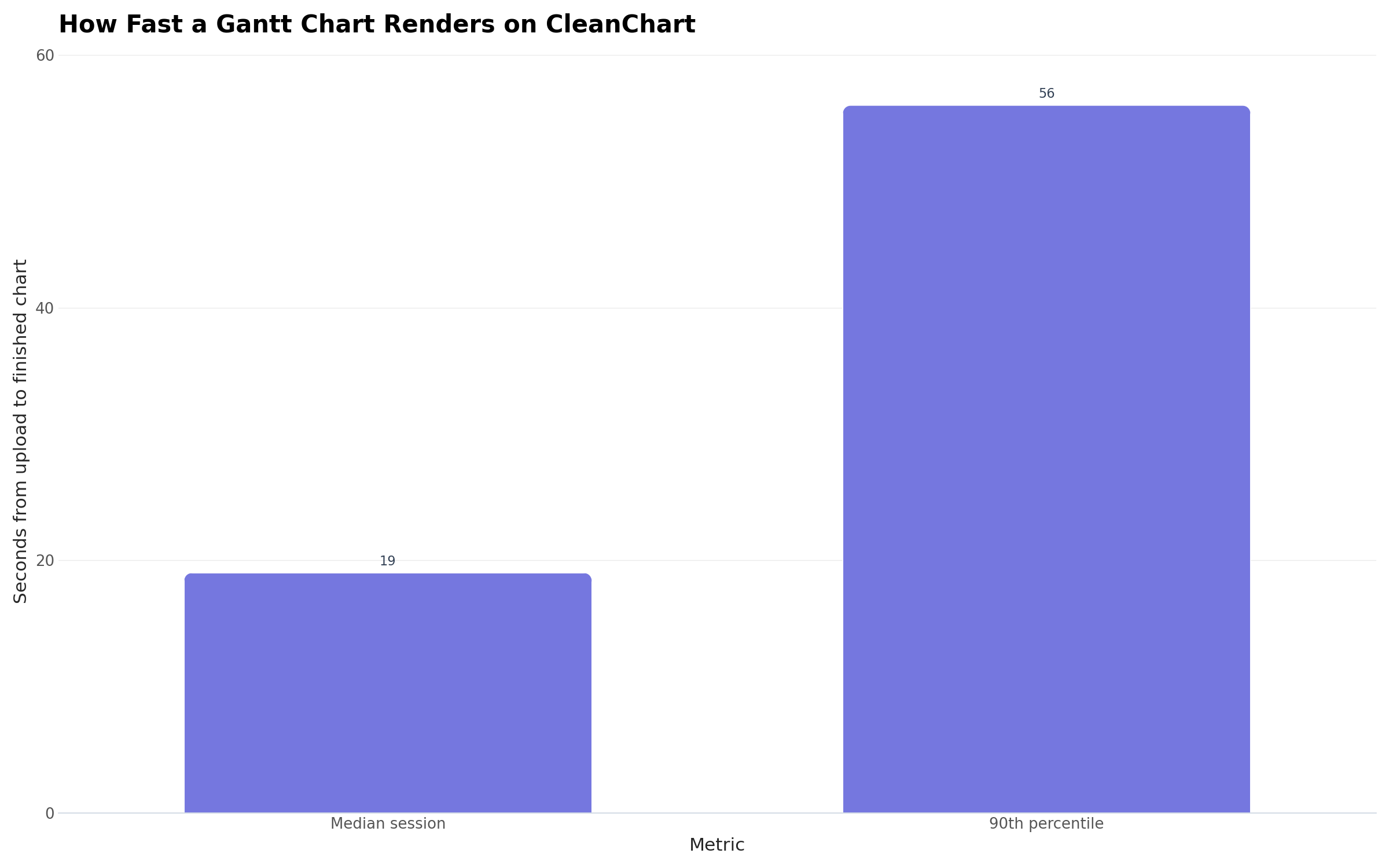

Bar chart showing time from upload to a finished Gantt chart on CleanChart: a median of 19 seconds and a 90th percentile of 56 seconds.
Takeaway: half of Gantt-chart sessions go from upload to a finished, rendered timeline in 19 seconds or less, and 90% finish within a minute. That is faster than logging into project management software, let alone setting one up. Source: CleanChart usage data (Gantt-chart sessions only), May–Oct 2026, n = 373. Download the data (CSV) and try it yourself in CleanChart's Gantt chart maker.

One more data point worth stating plainly: of the Gantt-chart sessions that ended in a download (n = 99, CleanChart usage data, May 12–Sep 13, 2026), every single one was exported as a PNG, none as SVG. People who build a Gantt chart from a task list want a flat image for a slide or a report, not an editable vector file.

Gantt Chart Examples by Industry

Software development sprint

TaskStartEndPhase
Sprint planningMar 1Mar 1Planning
Feature: User authMar 2Mar 8Development
Feature: DashboardMar 4Mar 12Development
Code reviewMar 12Mar 14QA
QA testingMar 13Mar 16QA
Sprint demoMar 17Mar 17Review

Event planning Gantt chart

TaskStartEndPhase
Venue selectionJan 1Jan 15Venue
Catering bookingJan 10Jan 31Vendors
Speaker outreachJan 5Feb 14Content
Marketing campaignFeb 1Mar 15Marketing
Registration opensFeb 1Mar 20Registration
Final logistics checkMar 18Mar 20Operations
Event dayMar 21Mar 21Event

Construction project Gantt chart

TaskStartEndPhase
Site preparationApr 1Apr 14Foundation
FoundationApr 10May 2Foundation
FramingMay 1May 28Structure
RoofingMay 20Jun 7Structure
Electrical rough-inJun 1Jun 21MEP
Plumbing rough-inJun 1Jun 21MEP
DrywallJun 22Jul 12Interior
Final inspectionJul 28Jul 31Closeout

Gantt Chart Best Practices

1. Keep task names short and action-oriented

Task names should be scannable at a glance. Use verb-noun format: "Write requirements," "Review design," "Deploy to production." Avoid long descriptions — save those for the project plan document.

2. Group tasks into phases

Color-code tasks by project phase (Planning, Design, Development, Testing, Launch). This makes the overall project structure immediately clear. Aim for 3–6 distinct phases for readability.

3. Show only the necessary level of detail

A Gantt chart for stakeholders showing the overall project trajectory is different from one for the development team showing individual daily tasks. Build separate charts for different audiences. For executive audiences, aggregate to weekly or monthly granularity.

4. Build in buffer time

Real projects always run over. Add 10–20% buffer before critical milestones. This is especially important for dependency chains — if the first task in a chain slips, every subsequent task slips too.

5. Limit to 15–20 tasks per chart

More than 20 tasks becomes hard to read in most presentation formats. Break large projects into sub-project Gantt charts if needed. For very complex projects, consider combining multiple chart types in your report.

6. Update it regularly

A static Gantt chart is a plan. A living Gantt chart is a tool. Update task bars as work progresses to keep stakeholders aligned. Use progress percentage bars to show how much of each task is complete.

Common Gantt Chart Mistakes to Avoid

Mistake #1: Too many tasks in one chart

Problem: A Gantt chart with 50+ tasks is unreadable, especially in a presentation slide or printed page.

Fix: Create a summary Gantt with rolled-up phases for executives, and detailed Gantt charts per phase for team members.

Mistake #2: Ignoring dependencies

Problem: Scheduling Task B to start before Task A finishes, creating an impossible timeline.

Fix: Always map your task dependencies first. Work backward from the deadline to identify the critical path.

Mistake #3: No milestones

Problem: A Gantt chart without milestones doesn't communicate key decision points or deliverables, leaving stakeholders uncertain about what "done" looks like.

Fix: Add milestone markers at key deliverables (design approval, go/no-go decision, launch date). Keep milestones to 3–5 per project.

Mistake #4: Using Gantt charts for the wrong data

Problem: Trying to show budget allocation, performance metrics, or survey results as a Gantt chart.

Fix: See our guide to common charting mistakes for the right chart type for each data scenario. A Gantt chart is specifically for task scheduling — for everything else, there's a better chart type.

Mistake #5: Wrong time scale

Problem: A 6-month project shown at daily granularity becomes unreadably small; a 2-week sprint shown at quarterly granularity loses all meaning.

Fix: Match the timeline granularity to the project duration. A 2-week sprint needs day-level granularity; a 12-month roadmap needs monthly granularity.

Gantt Chart vs. Alternatives

Chart Type Best For When to Choose Over Gantt
Waterfall chart Sequential value changes When you're tracking cost/budget flows, not task schedules
Funnel chart Stage-by-stage drop-off When you're tracking conversions or process yields, not timelines
Horizontal bar chart Category comparison When there's no time dimension — just ranked comparison
Line chart Trends over time When you're tracking a metric (revenue, users) over time, not tasks
Pareto chart Prioritization by impact When you want to identify which tasks/issues cause the most delays

For a comprehensive chart selection guide, see our complete chart types guide.

One-Off Gantt Charts vs. Project Management Software

Software like Asana, Monday.com or Microsoft Project treats a Gantt chart as a living view into an ongoing project, with tasks, owners and dependencies edited every day. A one-off (sometimes called "disposable") Gantt chart is the same chart with a different lifecycle: generated once from a task list you already have, exported as an image, and regenerated when the plan changes. It is the right call when the timeline needs to exist but doesn't need to be maintained:

  • Client or stakeholder updates – a clean visual for a status meeting or a proposal, not a shared workspace they'll log into.
  • One-off events – a wedding, a product launch, a conference or a renovation has a fixed timeline that doesn't repeat.
  • Small teams without PM software – if your team coordinates over chat or email, a full project management platform for one schedule is more setup than the task warrants.
  • Reports and slide decks – a Gantt chart in a PDF or a slide is inherently a snapshot, so an exported image is the natural format.
  • Early planning – before a project is greenlit, a rough visual to sketch out feasibility is all you need.
Aspect One-off Gantt chart Project management software
Setup time Minutes, no account setup for your team Hours to days: projects, users, permissions
Best for A single report, presentation or plan An ongoing project multiple people work in
Updates You regenerate the chart when the plan changes Task bars move as the team logs progress
Output A static PNG or SVG image An interactive dashboard inside the tool
Cost Free or low-cost for a single chart Recurring subscription, usually per seat

Plenty of projects genuinely need the second column: a construction schedule with dozens of interdependent tasks and several contractors updating status daily is a bad fit for a static export. If you're not sure which situation you're in, ask whether more than one person needs to edit the schedule after today. If the answer is no, a one-off chart from the Gantt chart maker is usually enough. See our guide on project management charts for how Gantt charts fit alongside other project visuals.

Frequently Asked Questions

What is the best free Gantt chart maker?

CleanChart's Gantt chart maker is free, browser-based, and requires no account or installation. You can upload CSV, Excel, or JSON data and export to PNG, SVG, or PDF. Other free tools include TeamGantt (limited free tier), Notion timelines, and Trello with the Timeline power-up.

Can I make a Gantt chart in Excel?

Yes, but it requires manually formatting a stacked bar chart to look like a Gantt. The process involves adding a transparent first series, adjusting axis formatting, and removing gridlines. It works but takes 20–30 minutes for a basic chart. For a comparison of Excel vs. dedicated tools, see our Excel vs. online chart makers guide. A dedicated Gantt chart maker like CleanChart produces the same result in under 2 minutes.

How do I add milestones to a Gantt chart?

Add a row for each milestone in your task list with the same start and end date (a single day). Many Gantt chart tools automatically display single-day tasks as diamond milestone markers. If your tool doesn't support milestones natively, use a distinct color and a 1-day duration to visually distinguish them from regular tasks.

What's the difference between a Gantt chart and a timeline?

A timeline shows events at specific points in time (no duration). A Gantt chart shows tasks with both a start and end date, plus potentially overlapping parallel tasks and dependencies. Gantt charts are a specific type of timeline visualization optimized for project management. For simple event timelines, a regular line chart or annotated line chart works well.

How many tasks should a Gantt chart have?

For presentation Gantt charts, 8–15 tasks is ideal. For working project management documents, up to 30 tasks per chart remains readable. Beyond that, break the project into sub-charts by phase or team. The goal is for a viewer to understand the full project schedule in 10 seconds or less.

Can I create a Gantt chart from Google Sheets?

Yes — use our Google Sheets to Gantt chart converter. Export your task data from Google Sheets as a CSV, then upload to CleanChart. Or share the sheet link directly and CleanChart will import the data automatically.

Do I need task dependencies for a Gantt chart to be useful?

No. A Gantt chart is useful as soon as you have tasks with start and end dates; dependencies and milestones are an optional layer on top. Add them when tasks genuinely block each other, otherwise a plain timeline is easier to read.

Can I create a Gantt chart without reformatting my dates first?

Yes, if the tool parses mixed date formats for you. CleanChart's automatic data cleaning standardizes inconsistent date formats before mapping the start and end columns, so you don't need to fix the date column by hand before uploading.

Can I make a one-off Gantt chart without project management software?

Yes. All you need is a task list with start and end dates in a CSV file, an Excel spreadsheet, or a Google Sheet. Upload it to the Gantt chart maker and export the result as an image; when the plan changes, update the spreadsheet and export a fresh chart rather than editing the image.
